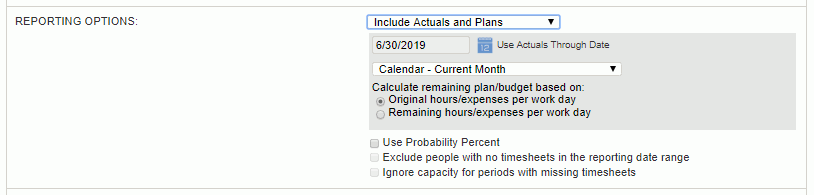

The Reporting Options selection criteria for this report allows you to specify:
Include Plans/Assignments/Actuals - Specifies whether this report is to include only Plans, or only Actuals, or only Assignments, or a combination of Actuals and Plans, or Actuals and Assignments.
Combining Actuals with Plans or Assignments -- When choosing an option that blends Actuals with either Plans or Assignments, you will need this control to specify the date through which the actuals should be considered and then from that point forward display Budget or Plan values.
Periodic Report Notes:
This control will only influence the calculated remaining allocated amounts for the plans and assignments that intersect with the Use Actuals Through Date.
When clicking through to a Periodic Report from a Chart (while using this Remaining option), note that the targeted periodic report will not reflect consistent/matching amounts (as the underlying report is unaware of the Actuals Through Date criteria from the original chart). You can, however, directly run the Periodic Report with this Remaining option and get accurate results.
Use Probability Percent -- When checked, the resulting amounts will be multiplied by the Probability Percentage recorded on each project. This option is not available when including Actuals Only.
The following options are only available when running the report with the 'Include Actuals Only' option.
Exclude people with no timesheets in the reporting date range - When checked, those users that have no timesheet for all time periods intersecting the reporting date range, will be excluded from the report all together.
Ignore capacity for periods with missing timesheets - When checked, a users capacity will be reduced to exclude hours for those time period dates where a timesheet does not exist (for days the user is intended to work - based on their business week definition).
This may be useful, for example, if you have part-time or sub-contractor users that come and go. This feature can be used to better reflect utilization in cases where users are not expected to work. Do note, however, that should a timesheet exist for a time period, the entire capacity for that timesheet (where it overlaps a report period column date range) will be included in the capacity. You may be able to further exclude capacity hours for users that only work a partial time period by having them charge the remainder of unworked days to a leave pay code and exclude that pay code from this report as well.
Capacity will be based on each user's business week and calculated as the number of business hours that fall within a particular periodic report column's date range, but only for those dates where the user has an existing timesheet (whether or not the timesheet has any hours on it is irrelevant).
When using this option, those cells in the report output that represent periods where the user had no active timesheet for the entire report output period, will be displayed with no color (ie white background) and a dash (vs. 0%), to help differentiate it from a period where they were expected to work but didn't.
Fixed Price Note: The Include Actuals control has no bearing on the way FP items are included in the report, why?
